Software Development Agreements: Negotiate Your Best Deal

Master your software development agreements. This guide reveals key clauses, hidden traps, and negotiation tactics to protect your IP and secure fair terms.

16 min read

Software Development Agreements: Negotiate Your Best Deal

You're probably staring at a contract right now that says all the comforting things. Clear deliverables. Professional tone. Maybe a neat signature block at the end.

And yet your gut says something's off.

That feeling is usually right. Most software projects don't blow up because somebody forgot how to code. They blow up because the agreement left too much room for argument. One side thought “MVP” meant a usable product. The other thought it meant a rough prototype. One side thought revisions were minor. The other treated them like an unlimited subscription. By the time everyone realizes the mismatch, the money and trust are already on fire.

I learned to treat software development agreements as operating rules, not paperwork. If the contract is vague, the project gets vague. If the contract is one-sided, every problem gets dumped downhill. If the contract is specific, the hard conversations happen early, when they're cheap.

Table of Contents

Your Project's Most Important File Is Not Code

A bad software project often starts with a sentence like this: “Developer will build a custom platform for Client.”

That sounds fine until the first disagreement. What counts as “build”? What counts as “done”? Who writes specs? Who signs off on changes? What happens when the client asks for “just one more workflow” two weeks before launch? If the agreement doesn't answer those questions, the project manager ends up doing improv, and improv is a terrible contract structure.

The shape of modern software development agreements didn't appear by accident. It grew out of complex installation contracts where scope, timing, approvals, and unexpected delays had to be managed in writing. A classic legal treatment of software contracting describes things like a master implementation schedule, named project managers for both sides, progress meetings, approval timetables, and mechanisms to roll dates forward when delays hit, all as core parts of the contract rather than administrative extras, as discussed in the historical law review analysis of software development contracting.

Practical rule: If a term affects delivery, acceptance, or money, it belongs in the agreement or an attached exhibit. Not in Slack. Not in someone's memory.

That old structure still works because software projects still fail in the same familiar ways. Requirements move. Dependencies break. Stakeholders change their minds. The contract's job is to turn that chaos into a process. Milestones. Approvals. Change control. Cure periods. Acceptance steps.

When people treat the agreement as a boring legal formality, they usually end up negotiating the actual terms later, in the middle of a dispute. That's the expensive version.

The Four Pillars of a Software Development Agreement

A workable agreement controls four things. Scope, timeline, IP, and payment. If one of those is sloppy, the whole deal gets slippery.

A useful legal guide puts it plainly: effective software development agreements act as a roadmap covering the project's scope and timeline, deliverables and acceptance testing, fees and payment milestones, implementation, and ownership of IP rights, as outlined in Myerson's guide to software development agreements.

A conceptual desk setup with four glowing pillars representing key components of software development agreements on a blueprint.

Scope decides what you are actually building

Scope is the blueprint. Not “build a dashboard.” More like: user roles, core workflows, integrations, browser support, admin permissions, reporting outputs, documentation, and handoff items.

Weak scope language creates fake alignment. Everyone nods yes because the words are broad enough to hide disagreement.

Good scope language does three things:

  • Defines the work product with exhibits, specs, and feature lists.
  • Separates included work from excluded work so “future phase” items stay future phase.
  • Connects scope to acceptance so the client can't invent new standards at the finish line.

Timeline turns promises into checkpoints

A timeline shouldn't be one heroic deadline. It should be a sequence of approvals and dependencies.

That means dates tied to actions by both sides. Client review windows. Content delivery deadlines. testing periods. Sign-off points. If the client delays feedback, the schedule should move with it. If the developer misses a milestone, the agreement should say what happens next instead of leaving everyone to posture over blame.

A project without milestone logic usually creates one of two bad outcomes. Either nothing gets enforced, or everything becomes an emergency.

IP ownership decides who can use the result

This clause looks simple until it isn't. Clients often assume they own everything. Developers often assume they keep pre-existing libraries, generic know-how, and reusable internal tools.

Both assumptions can be true, but only if the contract says so.

If the agreement says “all materials related to the project,” stop and ask whether that sweeps in your pre-existing code, templates, utilities, or frameworks.

The clean version usually distinguishes between project-specific deliverables and background materials. It also says when ownership transfers. On creation, on delivery, or only after full payment.

Payment terms control leverage

Payment language isn't just about price. It decides who carries risk during the project.

A few patterns tend to work better than others:

  1. Deposit first. If work starts before money lands, the developer is financing the project.
  2. Milestone billing beats vague progress billing. Tie invoices to defined deliverables or approvals.
  3. Late acceptance should not freeze payment forever. Set review windows and deemed acceptance rules where appropriate.
  4. Out-of-scope work needs its own approval path. Otherwise people argue after the work is already done.

If you read the contract through these four pillars, the rest of the clauses become easier to decode. Most of the legal language is just there to enforce one of these core controls.

Anatomy of the Agreement A Clause-by-Clause Breakdown

Software development agreements stop seeming abstract when issues emerge. Every bad surprise usually traces back to one clause that looked harmless during review.

Ten clauses that matter more than the rest

Below is the field guide version. Not law school. Just what the clause is doing, what it really means, and where people get trapped.

1. Deliverables

Typical idea: the developer will provide the software, documentation, and related materials described in the statement of work.

Plain English: this defines what must be handed over.

Red flag: deliverables are described at a high level with no exhibit, no feature list, and no documentation standard.

2. Acceptance criteria

Typical idea: the client will test the deliverable and either accept it or provide a written rejection notice.

Plain English: this is the finish line test.

Red flag: the contract says the client can reject work for any reason or doesn't set a review deadline. That opens the door to endless revision loops.

3. Change orders

Typical idea: any material changes to scope, schedule, or fees require a written change order.

Plain English: this is how you stop “quick asks” from becoming unpaid project expansion.

Red flag: the contract requires you to absorb reasonable changes without defining reasonable.

4. Payment terms

Typical idea: fees are payable by milestone, on invoicing, or after acceptance.

Plain English: this determines your cash flow and advantage.

Red flag: payment is tied only to final completion, especially on a long custom build.

5. Intellectual property ownership

Typical idea: the client gets rights in the final deliverables, while the developer keeps rights in pre-existing tools, methods, and materials.

Plain English: who owns what after the project ends.

Red flag: “work for hire” language that grabs everything connected to the project, including reusable components.

6. Warranties

Typical idea: the developer warrants that deliverables will materially conform to the agreed specifications for a limited period.

Plain English: you're promising the software will match the spec, not that it will be perfect forever.

Red flag: a warranty that effectively becomes free support for anything the client reports.

7. Limitation of liability

Typical idea: each party's liability is capped, often with carve-outs for specific serious issues.

Plain English: this puts a ceiling on worst-case exposure.

Red flag: your fees are modest but your liability is uncapped.

8. Indemnity

Typical idea: one party covers certain third-party claims caused by its own conduct or materials.

Plain English: if an outsider sues over a defined issue, this clause decides who pays and who controls the defense.

Red flag: one-sided indemnity where the developer covers broad client-side risks. If you want a better grounding before negotiating this point, this guide can explain indemnification clauses.

9. Confidentiality and data security

Typical idea: each side protects confidential information, and security obligations apply where data is involved.

Plain English: how carefully you must handle code, business information, credentials, and user data.

Red flag: security obligations that sound like enterprise procurement language but don't match the project or your setup.

10. Termination

Typical idea: either party may terminate for breach, insolvency, or convenience under stated conditions.

Plain English: the exit rules.

Red flag: the client can terminate at will, but the payment clause doesn't guarantee fees for work already performed or committed costs.

The best clause in the agreement is often the one that makes disagreement testable. If a delivery standard can't be verified, it can't really be enforced.

Key Clauses and Red Flags at a Glance

Clause What It Does Critical Red Flag
Deliverables Defines what must be handed over No detailed exhibit or feature description
Acceptance criteria Sets the conditions for approval Rejection allowed without objective criteria
Change orders Controls added work and timeline shifts “Reasonable changes” required without fee adjustment
Payment terms Determines when money is due Everything pushed to final delivery
IP ownership Allocates rights in code and materials Background tools swept into client ownership
Warranties Defines what the developer promises Open-ended bug fixing dressed up as warranty
Limitation of liability Caps financial exposure Your liability is uncapped or heavily carved out
Indemnity Allocates third-party claim risk Broad one-way obligation against the developer
Confidentiality and security Sets handling rules for sensitive information Security duties that exceed the project reality
Termination Defines exit rights and post-termination payment Client can exit freely without paying for completed work

Common Traps and Modern Gotchas

Some clauses don't look dangerous until you see how they work in a live project. The language sounds normal. The effect is not.

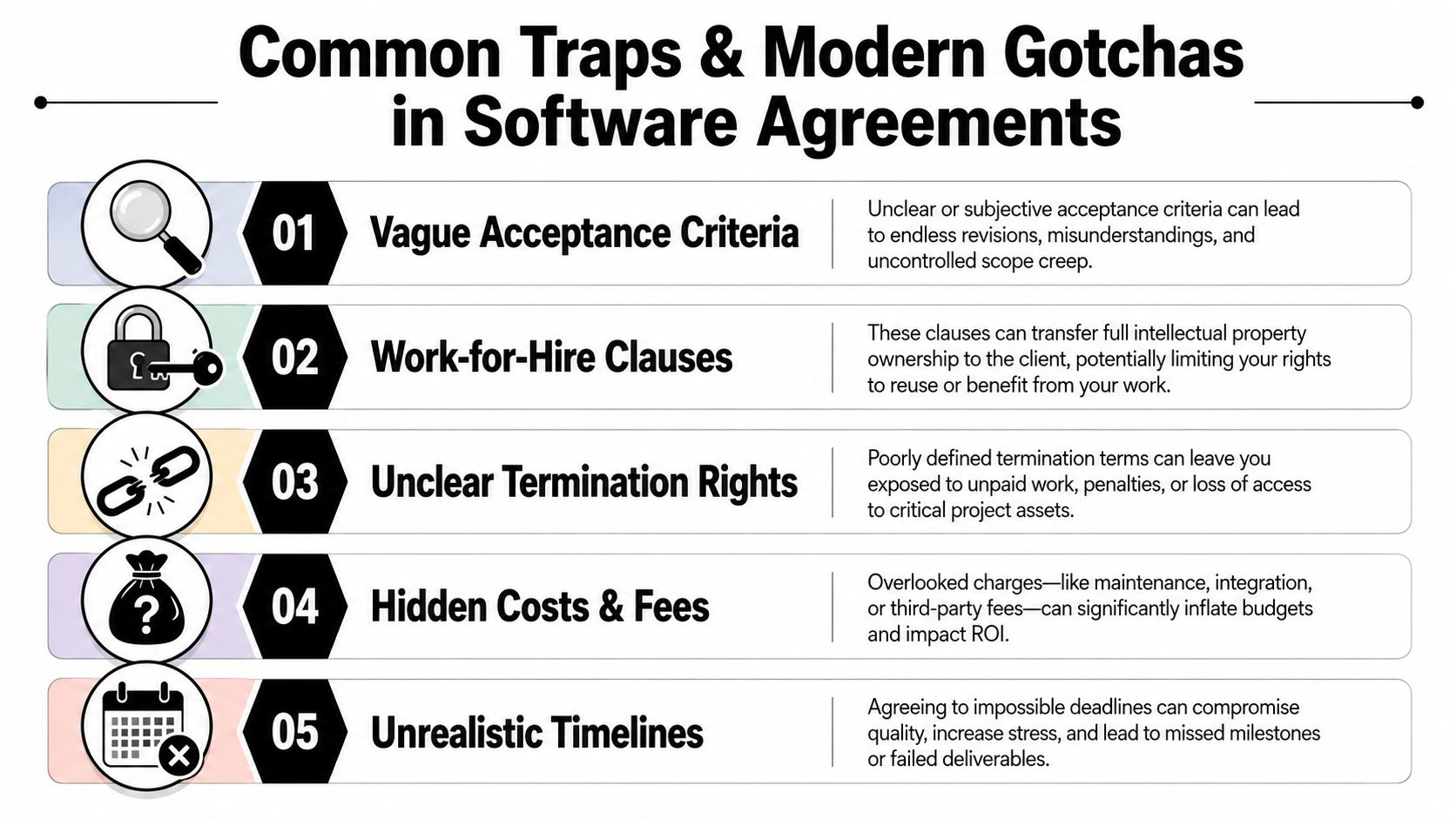

A list of five common traps and risks to watch out for in professional software development agreements.

The old traps still catch people

The first trap is vague acceptance. If the contract says the client accepts work when it is “satisfactory,” you're in trouble. Satisfactory to whom, and by what test? That wording lets a business preference masquerade as a technical defect.

The second trap is overbroad IP language. A client may ask for full ownership of custom deliverables, which is normal enough. The problem starts when the clause also captures anything “conceived, developed, or used” in connection with the project. That can swallow your starter code, internal utilities, deployment scripts, and methods.

The third trap is one-way risk transfer. You'll see this in indemnity, liability, and warranty sections. If the client provides content, instructions, or third-party tools, but the contract still makes you responsible for every resulting claim or failure, the allocation is upside down.

A quick sniff test helps. Compare what you control against what you're being asked to insure. If those don't match, push back.

For a broader list of contract problems that show up in freelance and small business work, these key freelance agreement warning signs map closely to what appears in software deals too.

AI and open-source risk changed the game

Often, a lot of templates are badly out of date.

Many software development agreements still focus on classic issues like scope, milestones, fees, liability caps, and IP assignment. But modern codebases are built with dependencies, snippets, packages, hosted components, and sometimes AI-assisted output. A simple “developer assigns all IP” clause doesn't answer the core questions.

A current legal discussion of software agreements highlights the gap by pointing to supply-chain evidence. The piece notes that the 2024 Synopsys OSSRA report found open-source code in 96% of audited codebases and license conflicts in 53% of those applications, which is exactly why modern agreements need more explicit treatment of provenance, compliance, and third-party risk, as summarized in LegalVision's discussion of software development agreement risks.

Don't accept a contract that talks like code appears from nowhere. It comes from people, tools, models, libraries, and dependencies. The agreement should reflect that.

What should be in the contract now?

  • AI use rules: whether AI-assisted coding is allowed at all, and in what parts of the workflow.
  • Disclosure duties: whether the developer must identify AI-generated output or open-source components used in the deliverable.
  • License compliance obligations: who reviews dependency licenses, and who resolves conflicts.
  • Third-party claim allocation: whether indemnities cover infringement allegations tied to model output or package provenance.
  • Remediation duties: what happens if a dependency or generated output must be replaced after delivery.

The mistake is assuming old IP language covers all of this. It doesn't. Ownership and provenance are different questions.

How to Negotiate Without Burning Bridges

Most contract fights get worse because people negotiate like they're trying to win a debate. That's the wrong frame. You're trying to lower ambiguity and rebalance risk so the project can survive normal friction.

A professional man and woman sitting at a table joining two large puzzle pieces together.

The cleanest way to do that is to tie every ask to something concrete. Strong agreements connect business objectives to written requirements, functional specifications, and measurable acceptance criteria, which makes negotiation easier because you can point to objective standards instead of personal preference, as explained in i-finity's guide to specification-backed software agreements.

Lead with clarity not outrage

Don't send a message saying a clause is “unfair” unless you want a defensive response. Say what the clause does in practice.

For example:

  • On payment: “Can we tie the second invoice to delivery of the staging build and written review, rather than open-ended acceptance?”
  • On IP: “I'm happy to assign project-specific deliverables, but I need an express carve-out for my pre-existing code, utilities, and general know-how.”
  • On indemnity: “I can cover claims arising from materials I create, but I can't take responsibility for client-provided content, instructions, or third-party tools chosen by the client.”
  • On acceptance: “Let's define acceptance against the feature list and test results in the SOW so both sides know what complete means.”

This works because it sounds like project management, not combat.

One line I use often: “I'm not trying to broaden the deal. I'm trying to make the current deal testable.”

After you frame the issue, propose replacement text or at least a principle. Redlines move faster when the other side doesn't have to guess what would satisfy you.

Phrases that get edits accepted

A few plain-English phrases travel well in email:

  1. “To avoid confusion later, can we make this more specific?”
    Good for deliverables, dependencies, and review periods.

  2. “I'm comfortable with the intent, but I need the clause narrowed to what I control.”
    Good for indemnity, warranties, and security obligations.

  3. “Can we separate project deliverables from pre-existing materials?”
    Good for IP sections.

  4. “I'd like payment tied to defined milestones rather than subjective completion.”
    Good for cash-flow disputes before they happen.

A short explainer on negotiation body language helps too. This video is a useful reminder that tone matters as much as markup when the other side is deciding whether to accommodate your edits.

If the client pushes back on everything, prioritize. Protect the clauses that can sink you: scope, acceptance, IP, liability, indemnity, payment timing, and termination. A perfect contract is rare. A survivable one is realistic.

Your Workflow From Draft to Signature Using Redline

A lot of people lose time by reviewing contracts in the wrong order. They start reading line by line before they've identified the clauses that can hurt them.

A simple review flow that keeps you organized

Use a repeatable workflow.

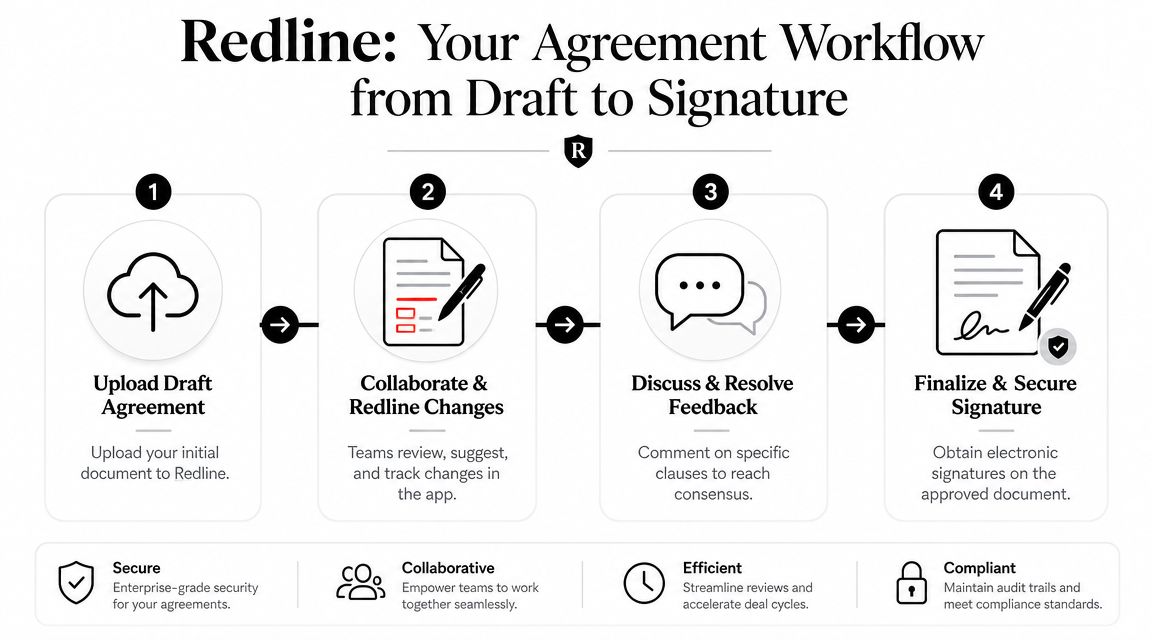

A four-step infographic illustrating the Redline agreement workflow process from draft to final electronic signature.

Step 1. Upload the draft and identify the document type
Start by loading the agreement into the Redline app. That gives you one place to review the base contract, attached SOW, and any exhibits that define deliverables or ownership.

Step 2. Scan for high-risk clauses first
Don't begin with recital language or boilerplate definitions. Look first for IP, acceptance, payment timing, indemnity, limitation of liability, confidentiality, termination, and change-order wording. The goal is triage. Find the clauses that can cost you money, lock up your code, or extend your obligations.

Step 3. Read the plain-English explanation against the actual text
This is the part people skip. A tool can flag a risk, but you still need to compare the explanation to the contract line itself. Check whether the issue is overbreadth, ambiguity, or a missing carve-out. Then decide whether it's a deal-breaker, a likely revision, or a term you can live with.

The fastest review method is not reading faster. It's sorting the clauses by damage potential.

Step 4. Draft pushback while the issue is fresh
Once you know what matters, turn comments into a concise response. Group related edits together. For example, put all scope and acceptance revisions in one note, and keep IP and indemnity in another. That makes it easier for the client or their counsel to respond without getting lost in scattered objections.

The point of a workflow like this isn't automation for its own sake. It's consistency. Software development agreements often reuse familiar language, but the dangerous part is always how the pieces combine in the specific draft in front of you.

The Final Pre-Signature Checklist

Before signing, do one last pass with a ruthless question in mind: if this project goes sideways, does the contract still make sense?

Use this checklist.

  • Scope is attached and specific: The SOW, exhibit, or requirements doc says what is included and what is not.
  • Acceptance is measurable: Approval depends on stated criteria, test results, functionality, or documentation standards. Not on general satisfaction.
  • Milestones are real: Dates connect to dependencies, review periods, and deliverables. They don't assume one side controls the whole schedule.
  • Change orders are mandatory: Added work, new integrations, and extra revision rounds require written approval.
  • Payment provisions offer security: Deposits, milestone invoices, and review deadlines are clear.
  • IP language is split properly: Project deliverables can transfer, but pre-existing tools, libraries, methods, and know-how stay carved out if that's your deal.
  • Warranty is narrow enough to survive: It covers conformity to agreed specs, not a forever obligation to fix anything anyone dislikes.
  • Liability cap is believable: Your downside matches the economics of the project.
  • Indemnity follows control: Each side covers the risks it creates.
  • Termination doesn't erase earned fees: If the project stops, payment for completed work and approved commitments is still protected.
  • Confidentiality and data duties fit the job: The obligations match the systems, access, and information involved.
  • AI and open-source use is addressed: The draft says what is allowed, what must be disclosed, and who carries compliance and third-party claim risk.

If even two or three of these are missing, don't assume goodwill will fill the gap. Good clients appreciate clarity. Difficult clients exploit ambiguity. The contract helps you tell which one you're dealing with before the work starts.


If you want a faster way to review software development agreements before you sign, Redline helps flag risky clauses, translate legal text into plain English, and turn your concerns into clean pushback you can send.
